Extra Large Unmanned Undersea Vehicle: Navy Needs to Employ Better Management Practices to Ensure Swift Delivery to the Fleet
Fast Facts
The Navy is trying to deploy five large, robotic submarines to do the dangerous job of laying undersea mines. But the effort is more than 3 years behind schedule and has exceeded costs by at least $242 million.
The Navy sees these robotic subs as a way to fill an urgent need—under DOD policy, this means ensuring that a solution can be delivered within 2 years. But the Navy didn't require the contractor to demonstrate that it was ready to build the subs within the planned cost and schedule. Seven years later, the Navy still doesn't have subs that meets its requirements.
Our recommendations could help the Navy better manage future sub purchases.

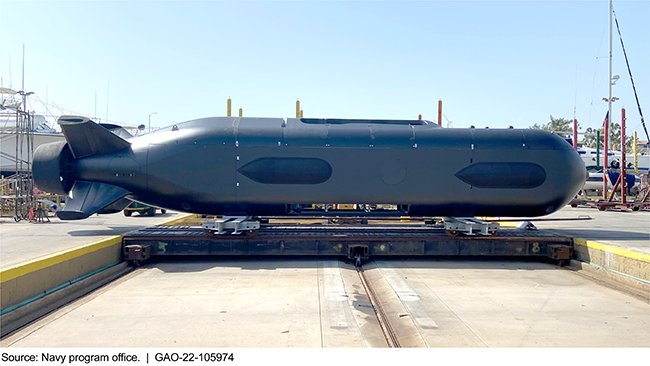

A Test Version of the Robotic Submarine
Highlights
What GAO Found
The Navy is attempting to rapidly deliver five Extra Large Unmanned Undersea Vehicles (XLUUV) to the fleet for deploying undersea mines without the need for sailors. However, the XLUUV effort is at least $242 million or 64 percent over its original cost estimate and at least 3 years late. The contractor originally planned to deliver the first vehicle by December 2020 and all five vehicles by the end of calendar year 2022. The Navy and the contractor are in the process of revising the delivery dates. But both expect the contractor to complete and deliver all five vehicles between February and June 2024.
Artist Rendering of the Extra Large Unmanned Undersea Vehicle
The contractor did not demonstrate its readiness to fabricate XLUUV because it was not required to do so. For acquisition programs, DOD and Navy typically conduct a production readiness review. While XLUUV is a prototype and not an acquisition program, the Navy plans to field the vehicles quickly. Key differences between the XLUUV and the contractor's prototype, the Echo Voyager, required the contractor to redesign critical components. Rather than address issues before starting fabrication, the contractor did not identify the full impact of these issues until after fabrication began. Then, significant delays were exacerbated by the COVID-19 pandemic. Further, the Navy has begun assessing the possibility of adding more capability and vehicles to this effort. If the Navy forgoes a production readiness review for its next XLUUV purchase, it risks beginning fabrication without information to assess the contractor's cost, schedule, and performance targets.
The Navy determined that XLUUV was critical to fulfilling an emergent need, which, under DOD policy, generally requires a capability be provided within 2 years. However, the Navy did not develop a sound business case, including cost and schedule estimates, to ensure that it could deliver the vehicles quickly to the fleet because XLUUV is a research and development effort. According to DOD urgent capability acquisition best practices, an acquiring organization should make cost and schedule trade-off decisions to get solutions to the fleet faster. Without more complete cost and schedule estimates, the Navy does not have the information it needs for decision-making and, thus, could continue experiencing cost overruns and schedule delays as it builds the XLUUV.
Why GAO Did This Study
The Navy is developing the XLUUV in response to a need to lay undersea mines. This ability could prevent an adversary from accessing strategic waterways and entry points on land. The Navy considers uncrewed autonomous vehicles to be prototypes that it is pursuing as a research and development effort. However, these XLUUVs are expected to serve a key role in the fleet and could protect sailors from performing dangerous missions.
The joint explanatory statement accompanying the Consolidated Appropriations Act, 2022, included a provision for GAO to review the XLUUV and the Navy's adherence to acquisition best practices. This report assesses (1) the extent to which the XLUUV is meeting cost and schedule targets, and (2) the Navy's efforts to develop, design, and produce the XLUUV compared to leading practices for product development.
GAO compared the XLUUV acquisition plan with the President's Budget for fiscal year 2023; compared XLUUV contracts, documents, and cost and schedule outcomes to leading practices for product development; and interviewed officials responsible for the XLUUV effort.
Recommendations
GAO is making two recommendations to the Navy, to (1) conduct production readiness reviews prior to additional purchases beyond the five XLUUVs, and (2) develop cost and schedule estimates to improve the feasibility of acquiring the vehicles in a timely manner. The Navy concurred with both of the recommendations.
Recommendations for Executive Action
Agency Affected | Recommendation | Status |
---|---|---|
Department of the Navy | The Secretary of the Navy should ensure that the office acquiring the XLUUV include a production readiness review as part of its acquisition strategy for any additional purchases of XLUUVs beyond the five prototype XLUUVs and the test vehicle it already purchased. (Recommendation 1) |
The Navy concurred with this recommendation. As of June 2024, the Navy plans to conduct production readiness reviews of additional XLUUVs prior to production start and these reviews are expected to be take place in fiscal year 2026. Currently, the Navy is also developing a follow-on acquisition strategy for the production of XLUUV systems that will include these reviews. Once completed, these reviews will better position the Navy to build the vessels according to the planned cost and schedule.
|
Department of the Navy | The Secretary of the Navy should ensure that the office acquiring the XLUUV develop more complete cost and schedule estimates that follow leading practices, such that the Navy can determine whether the contractor's planned timelines for the 5 prototype XLUUVs are achievable within planned costs. (Recommendation 2) |
The Navy concurred with this recommendation. As of June 2024, the Navy stated that it revised XLUUV cost estimates with actual cost data and has been working closely with the contractor to better understand the extent to which supply chain disruptions are affecting the timing of XLUUV deliveries. The Navy plans to finish a full cost estimate in fiscal year 2026. Without a complete estimate, the Navy cannot make a sound investment decision regarding the purchase of additional assets.
|
