Acquisition Reform:

DOD Should Streamline Its Decision-Making Process for Weapon Systems to Reduce Inefficiencies

GAO-15-192: Published: Feb 24, 2015. Publicly Released: Feb 24, 2015.

Additional Materials:

Contact:

Michael J. Sullivan
(202) 512-4841
sullivanm@gao.gov



Office of Public Affairs
(202) 512-4800
youngc1@gao.gov

What GAO Found

The acquisition programs GAO surveyed spent, on average, over 2 years completing numerous information requirements for their most recent milestone decision, yet acquisition officials considered only about half of the requirements as high value. The requirements, in total, averaged 5,600 staff days to document.

Average Time 24 DOD Programs Needed to Complete Information Requirements Grouped by the Value Acquisition Officials Considered Milestone B and C Requirements

Average Time 24 DOD Programs Needed to Complete Information Requirements Grouped by the Value Acquisition Officials Considered Milestone B and C Requirements

The Department of Defense's (DOD) review process is a key factor that influences the time needed to complete information requirements. The process in some instances can include up to 56 organizations at 8 levels and accounts for about half of the time needed to complete information requirements. Most program managers felt that these reviews added high value to only 10 percent of the documents.

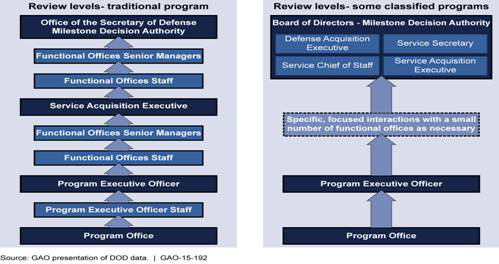

Comparison of Review Levels for DOD Traditional and Classified Programs

Average Time 24 DOD Programs Needed to Complete Information Requirements Grouped by the Value Acquisition Officials Considered Milestone B and C Requirements

DOD's F-16 aircraft program, some classified programs, and five commercial firms GAO visited use streamlined processes with fewer documents and reviews and offer alternatives to the traditional DOD process. Establishing an efficient process for documentation and oversight is a key internal control to avoid wasteful spending. The challenge is to find the right balance between effective oversight and the competing demands on programs. DOD, however, has not yet identified ways to achieve the right balance by minimizing the time spent on information requirements and reviews that contribute to its inefficient milestone decision process.

Why GAO Did This Study

DOD has long sought to improve the efficiency of its weapon system acquisition process, including the time and effort needed to complete the milestone decision process.

The National Defense Authorization Act for Fiscal Year 2014 mandated GAO to review DOD's weapon system acquisition process. This report examines (1) the effort and value involved in the preparation for a milestone decision; (2) factors that influence the time needed to complete the milestone decision process; and (3) alternative processes used by some DOD programs and leading commercial firms.

To perform this work, GAO examined the levels of review and information requirements that are part of DOD's process. GAO surveyed 24 program managers and 40 other DOD officials on the value and the time to complete milestone documentation. For 15 program offices, we gathered data on the time to complete the entire milestone decision process. GAO discussed with DOD officials the factors that lead to inefficiencies. GAO also examined practices used by some classified DOD programs and five commercial firms generally recognized as leaders in product development.

What GAO Recommends

GAO recommends that DOD identify and potentially eliminate reviews and information requirements that are no longer needed and select programs to pilot more streamlined approaches to provide only the most essential information to decision makers. DOD concurred with both recommendations.

For more information, contact Michael J. Sullivan, (202) 512-4841 or sullivanm@gao.gov.

Recommendations for Executive Action

  1. Status: Closed - Implemented

    Comments: DOD has taken a number of steps to implement this recommendation. The Office of the Secretary of Defense (OSD) issued a policy directive called Better Buying Power 3.0 (BBP 3.0) in April 2015, which contains a section on streamlining documentation requirements and staff reviews. This was followed by the Office of the Under Secretary of Defense for Acquisition, Technology and Logistics issuing a memorandum that identified actions to be taken to address this BBP 3.0 section, including guidance and specific actions to streamline documentation requirements and staff reviews that are part of the defense acquisition system. The memorandum states that DOD officials are now expected to suggest options to condense the staffing review process, reduce the content of documents, or completely eliminate documents. In November 2015, the National Defense Authorization Act for Fiscal Year 2016 (P. L. 114-92) effectively reduced the number of review levels for major acquisition programs by changing the milestone decision authority for these program from OSD's Office of the Under Secretary of Defense for Acquisition, Technology and Logistics to the service acquisition executives of the military services. Further, all three military services have implemented, or are in the process of implementing actions to streamline information requirements in the defense acquisition system. The military services all now use an Electronic Coordination Tool to facilitate review, comment, and approval of documents within 14 days of receipt. The Air Force now provides specific direction to their acquisition programs to identify a particular strategy for streamlining documentation. In May 2017, the Air Force also issued a revised acquisition instruction, Air Force Instruction 63-101/20-101 Integrated Life Cycle Management, that minimizes or streamlines unique documentation, requirements, and processes. The Navy has received program documentation tailoring approval from OSD for several programs including the PA-8 Increment 3, Virginia Class Submarines, and the Littoral Combat Ship. In 2016, a comprehensive review by the Army identified 17 percent of Army-unique acquisition documentation requirements that could be eliminated. In June 2017 the Army revised its acquisition policy, AR 70-1, to reduce the scope and size of non-value added documentation and processes and reduce Army-unique requirements.

    Recommendation: To help improve DOD's milestone decision process, the Secretary of Defense should direct the Under Secretary of Defense for Acquisition, Technology and Logistics in collaboration with the military service acquisition executives, program executive officers, and program managers to, in the near term, identify and potentially eliminate (1) reviews associated with information requirements, with a specific focus on reducing review levels that do not add value, and (2) information requirements that do not add value and are no longer needed. For the remaining reviews and information requirements, evaluate and determine different approaches, such as consolidating information requirements and delegating approval authority, which could provide for a more efficient milestone process. This effort should also include a re-examination of the reason(s) why an information requirement was originally considered necessary in order to determine what information is still needed and if a more efficient approach could be used. Findings and survey responses included in this report could be used as a starting point for this examination.

    Agency Affected: Department of Defense

  2. Status: Open

    Priority recommendation

    Comments: DOD concurred with the recommendation and has taken some actions to implement it for major defense acquisition programs (MDAPs) and other acquisition programs. For example, the Office of the Secretary of Defense issued a policy directive called Better Buying Power 3.0 in April 2015, which stated that the military services would identify MDAPs to pilot streamlined acquisition processes. The Navy did designate one MDAP-the Next Generation Mid-Band Jammer-as a pilot program in 2015 and has implemented policies that appear to streamline some program processes. The Air Force and Army have not pilot tested streamlined acquisition approaches for any MDAPs. Each of the military services is, however, currently taking advantage of a new authority granted by the Congress in Section 804 of the Fiscal Year 2016 National Defense Authorization Act to streamline the acquisition processes for programs that could be completed in 2 to 5 years. These programs are referred to as middle-tier acquisitions and are not considered MDAPs. As such, they are not subject to the same statutory and regulatory documentation requirements as MDAPs. The Under Secretary for Acquisition and Sustainment is allowing each of the military services to pilot middle-tier acquisition authority using their own approaches and then plans to issue final guidance in the fall 2019 based on the military services' experiences. As of March 2019, the military services had started 35 programs under the middle-tier acquisition authority. Even given this new Section 804 authority, the military services told us that they will continue to start MDAPs because middle-tier acquisition authority is not appropriate for all new programs. Therefore, we believe the Air Force and Army should pilot streamlined acquisition approaches for MDAPs.

    Recommendation: To help improve DOD's milestone decision process, the Secretary of Defense should direct the Under Secretary of Defense for Acquisition, Technology and Logistics in collaboration with the military service acquisition executives, program executive officers, and program managers to, as a longer-term effort, select several current or new major defense acquisition programs to pilot, on a broader scale, different approaches for streamlining the entire milestone decision process, with the results evaluated and reported for potential wider use. The pilot programs should consider the following: (1) Defining the appropriate information needed to support milestone decisions while still ensuring program accountability and oversight. The information should be based on the business case principles needed for well-informed milestone decisions including well defined requirements, reasonable life-cycle cost estimates, and a knowledge-based acquisition plan. (2) Developing an efficient process for providing this information to the milestone decision authority by (a) minimizing any reviews between the program office and the different functional staff offices within each chain of command level and (b) establishing frequent, regular interaction between the program office and milestone decision makers, in lieu of documentation reviews, to help expedite the process.

    Agency Affected: Department of Defense
